Software development cost assessment evaluating pricing fairness and budget efficiency

Key takeaways

The rate is rarely the problem; the hours are. Most overpayment comes from paying for avoidable hours (rework, scope creep, coordination), not from a headline rate that is a few dollars too high.

Custom software development cost in 2026 spans a 6x range. Loaded rates run about $30-48/hr offshore, $55-88 mid-tier, and $150-240 US senior. A cheap rate at 1.8x loaded cost can beat a mid rate at 1.4x, or lose to it.

A cheap quote often costs the most. A defect caught in production can cost tens of times more than the same defect caught at design time, so skipping discovery and QA is false economy.

Fixed price is not automatically cheaper. It carries a risk premium plus change orders. On moving scope, time & materials usually costs less in total.

You can audit a quote in 30 minutes. Ask for the hour breakdown, the seniority mix, and who runs coordination. Vague answers, not high numbers, are the real red flag.

Why Fora Soft wrote this

You signed a contract, the invoices keep landing, and something feels off. Maybe the number crept past the estimate. Maybe you met senior engineers in the sales call and now talk only to juniors. That nagging feeling, “am I overpaying?”, is worth taking seriously, because it is usually right about something, even when it is wrong about the rate.

We are Fora Soft. We have built custom software since 2005: 250+ products with a 50-engineer in-house team and a 100% job-success score across 935 Upwork contracts. We have written fair quotes, and we have been hired to rescue projects after someone else wrote an unfair one. So we have seen both sides of the invoice: where money genuinely has to go, and where it quietly leaks.

This is not a pitch dressed up as advice. It is the checklist we would hand a friend who suspects their vendor is charging too much. We will show what custom software development actually costs in 2026, where your money goes, the five signals that you are overpaying, and how to sanity-check a quote before the next invoice. When the honest answer is “you are not overpaying,” we will say that too.

Not sure your invoice adds up?

Send us your quote or last invoice. We will tell you, free and with no pitch, whether the hours and rate look fair for what you are building.

Book a 30-min call →WhatsApp →Email us →

Are you actually overpaying?

Usually the money is leaking through the hours, not the rate. A vendor billing $60/hr who needs 3,000 hours because requirements were vague will cost you $180,000. A vendor billing $85/hr who needs 1,400 hours because they scoped the work first will cost you $119,000. The “cheaper” rate lost by $61,000. So the first question is not “is my rate too high?” but “am I paying for hours I should not have to?”

There are really three ways to overpay, and they need different fixes. You can pay a rate above what your work warrants (rare, and easy to check). You can pay for too many hours because of rework, scope creep, and thin coordination (common, and expensive). Or you can pay a fair rate for the wrong thing entirely, like a gold-plated build when an MVP would have proven the idea. Most people who feel overcharged are living in the second bucket.

The rest of this guide helps you tell which bucket you are in. We start with the raw numbers, because you cannot judge a quote without a reference range.

Reach for a second opinion when: your effective cost per shipped feature keeps rising, change requests are waved through without a written impact estimate, or nobody can tell you how many hours went to rework last month.

What custom software development cost looks like in 2026

Loaded developer rates in 2026 run roughly $30-48/hr offshore, $55-88/hr mid-tier (Eastern Europe and senior Latin America), and $150-240/hr onshore in the US. Those are the loaded numbers: the headline rate plus the overhead you actually pay for. Whole projects land wherever hours meet rate: a focused MVP often runs $40,000-$120,000, a production platform $120,000-$400,000, and enterprise systems higher.

Ranges this wide are not a dodge; they reflect real differences in scope, seniority, and where the team sits. The mistake is treating a single number as “the price” of software. There is no more a fixed price for “an app” than there is for “a building.” A landing page and a HIPAA-grade telehealth platform are both “software.”

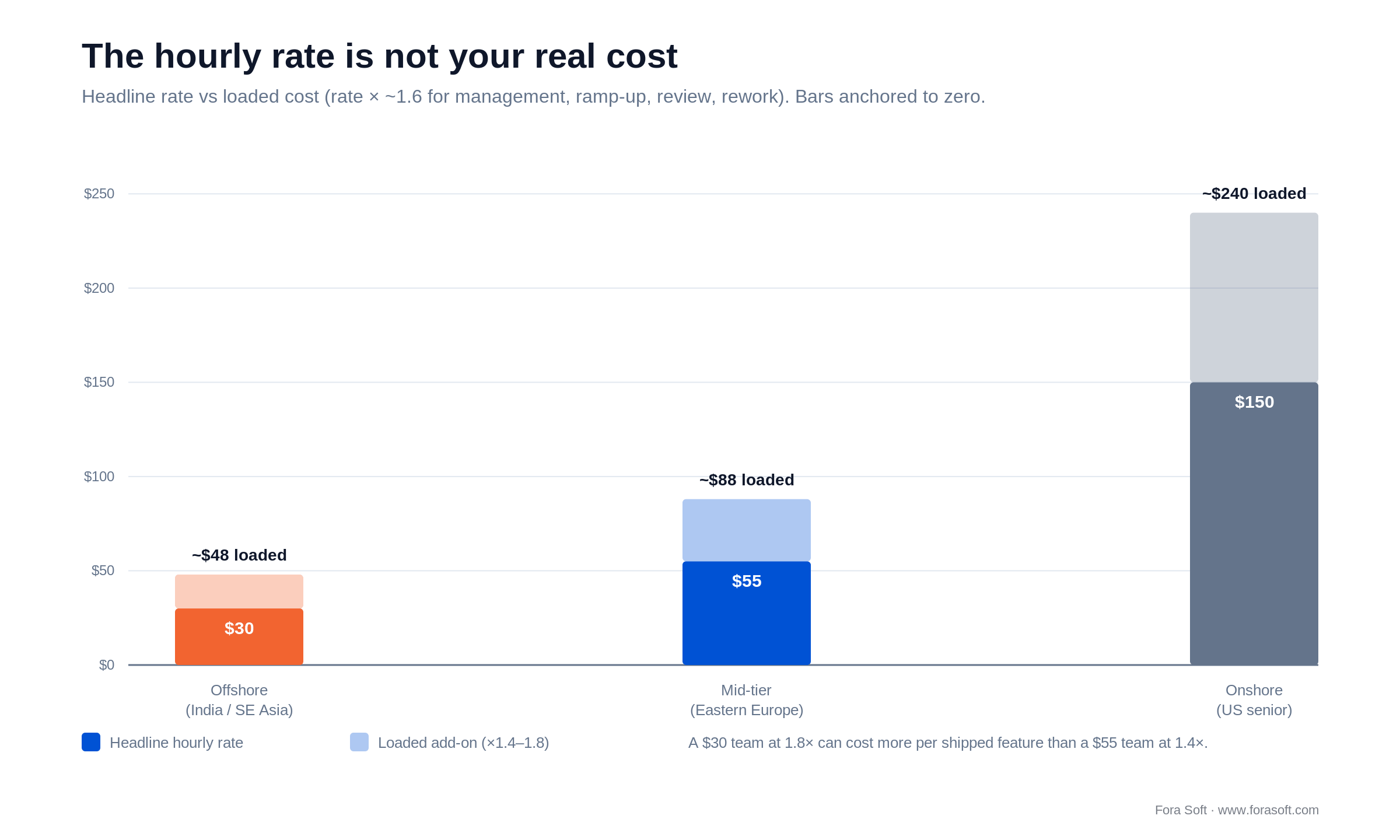

Headline hourly rate vs loaded cost: a $30 offshore rate loads to ~$48, a $55 mid-tier rate to ~$88, US senior to ~$240

Figure 2. Headline rate vs loaded cost by region. The rate you are quoted is not the cost you carry.

Two numbers do the most damage when they are missing from a quote: the seniority mix (three seniors ship differently than one senior and five juniors) and the hours estimate behind the total. A vendor who gives you a total without either is asking you to trust a black box. Our guide to estimation methods walks through how a credible estimate is actually built.

Onshore, nearshore, offshore: what you are really paying for

The right location is the one where total delivered cost is lowest, not the one with the smallest hourly rate. A lower rate with thin time-zone overlap and heavier rework can end up more expensive than a mid rate with live communication. Here is how the four common models compare on the things that actually move your bill.

ModelLoaded rate/hrTime-zone overlapMain cost riskBest for
Onshore (US / UK)$150-240FullPaying senior rates for routine workRegulated, on-site, board-facing builds
Nearshore (Latin America)$45-75Strong (US hours)Uneven senior depth by countryUS teams wanting live overlap
Mid-tier (Eastern Europe)$55-88Partial (EU / AM overlap)Vetting depth varies by shopBest value for most product builds
Offshore (India / SE Asia)$30-48Thin (night calls)Rework and coordination overheadWell-specified, low-ambiguity work

Reach for mid-tier (Eastern Europe) when: you want the best balance of senior depth, communication, and price for a typical product build — it is where our own team sits, and where most projects get the lowest total cost.

Reach for offshore when: the work is well-specified and low-ambiguity (a defined API, a clear feature backlog) so the rework risk that eats offshore savings stays low.

If your product lives in a specialized domain — video, streaming, real-time — location matters less than depth. A team that already knows the stack avoids the expensive trial-and-error that inflates hours. Our Learn hub on video encoding is the kind of domain knowledge that keeps a build from paying tuition on your dime.

Why the hourly rate is not your real cost

Budget 1.4x to 1.8x the headline rate. The quoted number pays a developer to type. Your real cost also covers project management, code review, onboarding ramp-up, meetings, and the hours lost to attrition when someone leaves mid-project. That multiplier is why a $30/hr offshore team can quietly cost $48/hr, and a $55/hr mid-tier team about $88/hr.

Run the arithmetic once and it changes how you read every quote. Take a feature estimated at 100 developer-hours. At a $30 headline rate it looks like $3,000. Load it at 1.8x for the coordination a distributed junior team needs, and it is $5,400. The same feature with a $55 team that scopes tightly and loads at 1.4x is $7,700 — more per hour, but if that team ships it in 70 hours instead of 100, you pay $5,390 and get it two weeks sooner. Rate lost; hours won.

This is the single most common way founders misjudge a quote: they compare headline rates side by side and pick the low one, without asking how many loaded hours each team will actually burn. The cheap rate is a number on a page. The loaded hours are the number on your bank statement.

Where the money actually goes

In a healthy build, development is 40-50% of the budget, QA is 20-25%, and discovery, design, and deployment take 10-15% each. When one line swallows everything, usually development because rework hides there, that is your signal that hours are leaking upstream, in requirements and design.

Where a custom software build budget goes: development 40-50%, QA 20-25%, discovery, design and deployment 10-20% each

Figure 1. Typical share of a build budget. When development swallows everything, rework is usually hiding in it.

The line people cut first is the one that saves the most: discovery and design. Skimping there does not remove the work; it defers it into development as expensive rework, where the same decision costs several times more to change. Design is the most under-funded line in the industry, and poor UX quietly raises support costs for years after launch.

One number reframes the whole conversation: the build is not the big cost. Over a system's life, maintenance typically runs 60% or more of total cost of ownership (IEEE Computer Society), so lifetime upkeep commonly totals two to four times the original build. A quote that looks expensive today can be cheap if it produces clean, maintainable code, and a bargain build that ships spaghetti will bill you back every year you own it.

The cheap-vendor trap: why the lowest quote can cost the most

The lowest bid usually wins by removing the two things that keep a project cheap: discovery and early QA. Take them out and the price on page one drops, but the cost of every defect climbs. A bug caught while writing requirements is nearly free to fix. The same bug caught in production can cost tens of times more, because you pay to find it, fix it, re-test it, and apologize for it.

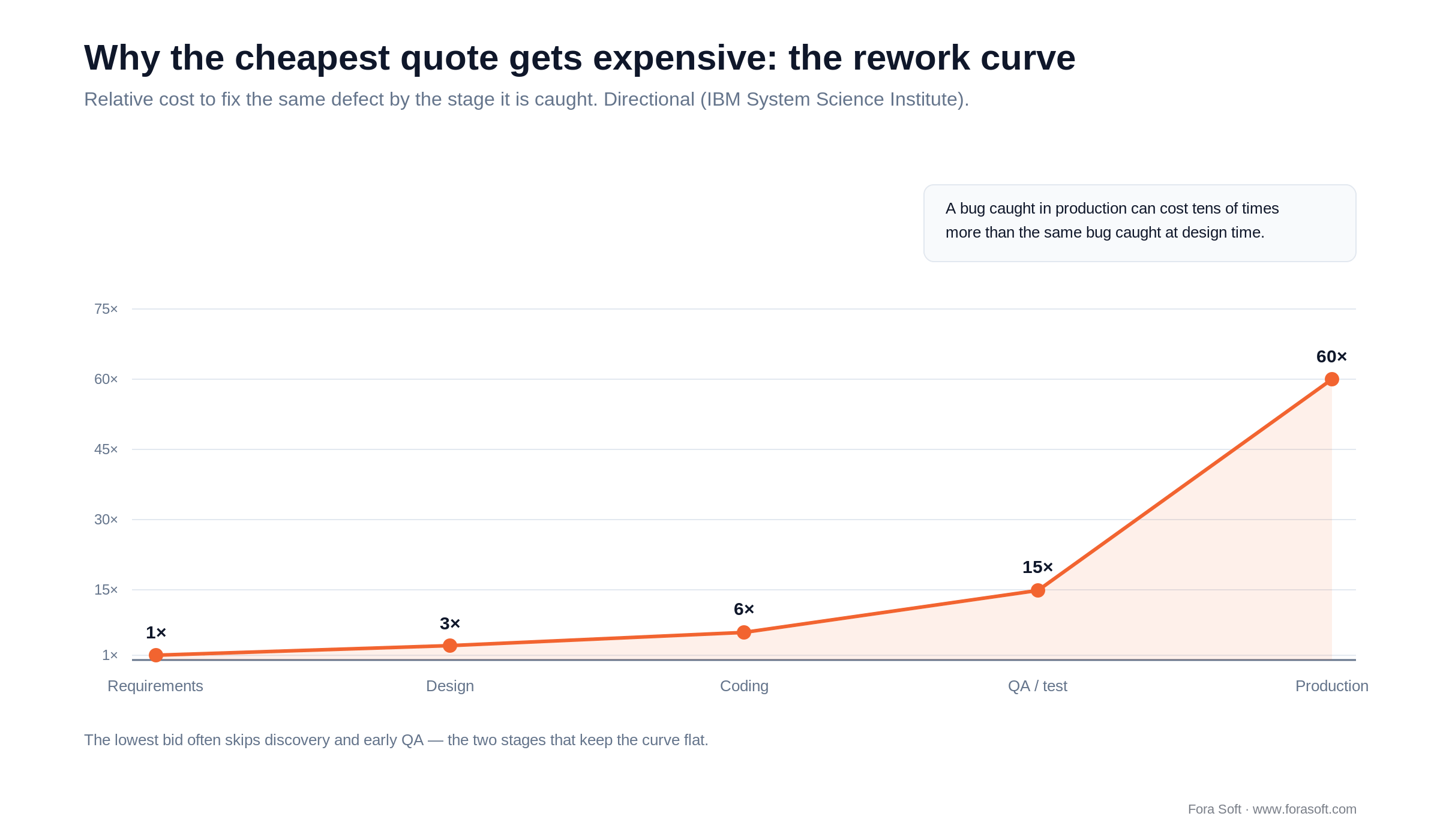

Rework cost curve: a defect costs 1x at requirements and up to 60x in production, so skipping early QA gets expensive

Figure 3. The rework curve. A defect gets an order of magnitude more expensive at each stage it survives.

This is not a small effect. The Consortium for Information & Software Quality put the cost of poor software quality in the US at $2.41 trillion in 2022, with accumulated technical debt around $1.52 trillion. Most of that is rework: hours spent redoing what should have been done once. When a quote is dramatically lower than the others, the honest question is what got deleted to get there, because the work does not disappear. It just moves to a more expensive stage, and lands on your invoice as “unexpected” hours.

Cheap and expensive are not about the rate. They are about how many times you pay for the same feature.

Worried the low bid will bite later?

We will review a proposal you have received and flag where the hours are likely to blow out — before you sign, not after.

Book a 30-min call →WhatsApp →Email us →

Five red flags you are overpaying

1. A confident fixed price after one meeting. If a vendor quotes a firm number before asking hard questions about scope, one of two things is true: they padded the price to cover everything they do not yet understand (you overpay for their uncertainty), or they under-scoped to win the deal and will bill the gap back as change orders. A quote with no questions attached is not a price. It is a guess with a decimal point.

2. Bait-and-switch on seniority. You met senior engineers in the sales process, signed, and quietly got handed a team of juniors billed at the same rate. This is structurally common in volume shops whose model depends on selling senior rates for mid-level work. Ask who specifically is on your team, and check their names against the people in the sales call.

3. No project management line. If the offer is “here are four developers” with nobody owning coordination, that cost has not vanished — it has moved to you. Unmanaged teams drift, duplicate work, and rebuild things twice. A missing PM is not a discount; it is a hidden invoice.

4. Rates the vendor cannot itemize. A team that will not break the total into hours by role and phase is asking you to trust a black box. Any credible vendor can show you the shape of the estimate. If they refuse or wave it off, you cannot tell what you are buying — which is exactly the condition in which people overpay.

5. Change requests waved through. Every “sure, we can add that” with no written impact estimate is budget leaking in real time. Healthy vendors respond to a new feature with a cost and a timeline shift before they build it, so you decide with the number in front of you. If yours just nods, your scope, and your bill, grow without a decision.

Fixed price vs time & materials: which one quietly costs more

Fixed price is not automatically the cheaper option. To commit to a fixed number, a vendor has to absorb all the risk of the unknown, and they price that risk in. You pay a premium for certainty, plus change orders every time reality diverges from the spec. On any project where scope will move (which is most of them), time & materials usually costs less in total, because you pay for the work that actually happened, not for a buffer against work that might.

Fixed price vs time and materials: fixed price hides risk premium plus change orders (~$120k) vs T&M actual hours (~$88k)

Figure 4. Same scope, two contracts. Fixed price buys predictability; on moving scope it usually costs more.

Fixed price earns its keep in exactly one situation: the scope is genuinely frozen and well-specified, and neither side expects it to change. A defined integration, a clear migration, a spec you would bet on — fixed price is fine, even preferable. The trouble starts when a fixed contract meets a moving product, and every learning becomes a change order at a marked-up rate.

If you are on a fixed-price contract and feel overcharged, look at the change-order history first. That is where fixed-price projects leak — not in the base number you agreed to, but in the additions you approved one at a time without watching the total.

The six budget leaks, and the fix for each

When a project runs hot, the cause is almost never a single villain. It is a handful of small leaks that compound. Here are the six we see most, and the cheapest fix for each — the modern version of the checklist this article has run on for years.

Vague requirements

Weak requirements are the most expensive document you never wrote. Developers guess, testers find the guess was wrong, and you pay for the redo. The fix is boring and it works: before any code, write detailed user stories with acceptance criteria and cover the edge cases. Add wireframes so everyone sees the same product. Tight requirements are the highest-return hours in the whole budget.

No development plan

Without a sequenced plan, tasks get built in the wrong order and redone when a dependency shifts. A project manager who maps milestones, spots a slipping task in week one instead of week six, and plans around vacations pays for their own cost many times over. A plan is not overhead; it is the thing that stops overhead.

Unmanaged change

Every new idea mid-build is fine — as long as it goes through a gate. Ask for a written impact estimate (cost, timeline, release effect) before a change is built, then decide. The leak is not the changes; it is approving them without seeing the number.

Wrong priorities

A team polishing button colors while the core feature slips is burning money at full rate. Order the backlog by business value, build in that order, and share the list so nobody quietly reshuffles it. Effort spent on the wrong thing costs exactly as much as effort spent on the right thing.

Shaky architecture

A weak foundation makes every later feature slower and buggier. We review the intended architecture with senior engineers who are not on the delivery team before building — an outside read that catches expensive mistakes while they are still cheap to change. For a project already underway, an independent code audit is the fastest way to find where quality (and money) is leaking.

Thin testing

Skipping QA does not save the test hours; it converts them into production bugs at many times the cost (see the rework curve above). Test early, in parallel with development, so defects die young. The cheapest bug is the one caught the day it was written.

A worked example: how a $180k quote becomes $95k

Here is a realistic path from a $180,000 quote to a fair $95,000 — a 47% cut with no magic, just discipline. The point is not the exact numbers (your mix will differ); it is that most overpayment is recoverable through four ordinary levers, not through haggling on the rate.

Worked example: a $180k quote drops to $95k via MVP scope, right-shoring, less rework and reuse - a 47% cut

Figure 5. How four honest levers take a $180k quote down to $95k, no rate haggling required.

Trim to MVP scope: −$45k. Many features in a first quote are really version-two features in disguise, and classic Standish data found much of what gets built is rarely or never used. Cut the build to what proves the idea with real users, and the rest waits until you know it is worth building. Our guide to cutting features for an MVP shows how to decide what stays.

Right-shore the team: −$22k. Move routine work off senior onshore rates to a mid-tier team with real communication overlap. You keep the quality where it matters and stop paying premium rates for plumbing.

Kill avoidable rework: −$12k. Tight requirements and early QA (the two levers from the leak list) remove the redo hours that quietly padded the original estimate.

Reuse instead of build: −$6k. Auth, payments, notifications — buy the commodity pieces instead of hand-rolling them. Spend your custom budget on what makes your product different, not on rebuilding solved problems. Net result: $95,000 for the same product that started at $180,000.

Want this done on your numbers?

Give us your scope and current quote. We will map the same levers to your project and show where a fair price actually lands — free, no obligation.

Book a 30-min call →WhatsApp →Email us →

How to audit your quote in 30 minutes

You do not need to be technical to pressure-test a quote. You need three answers. Ask your vendor for them in writing, and the vague responses will tell you more than the numbers.

  • The hour breakdown. Total hours by role (dev, QA, design, PM) and by phase. A credible team hands this over. A team that will not is asking you to trust a black box.
  • The seniority mix. Who, by name, is on your team, and at what level. Cross-check against the people in the sales call. Senior rates for a junior team is the most common overcharge.
  • Who owns coordination. The named person responsible for planning, change control, and keeping the team from redoing work. If the answer is “the developers self-manage,” expect drift.

Then do two arithmetic checks. Divide the total by the hours to get the effective rate, and compare it to the ranges above for the team's location. And ask what percentage of last month went to rework — anything above roughly 15% is a leak worth investigating. None of this requires you to read code. It requires you to ask for numbers and watch how readily they come.

If the answers are clear and the math holds, you are probably paying a fair price. If they are evasive, you have found your problem — and it was never the rate.

Are you overpaying? A decision in five questions

Run your project through these five. Each “no” is a place money is likely leaking.

1. Can you see the hours? If the vendor cannot show a breakdown by role and phase, you cannot judge the price — and unpriceable work is where overpayment hides.

2. Is the team you signed the team you have? Same seniority, same names as the sales call. If not, you may be paying senior rates for junior output.

3. Does every change come with a number? New features should arrive with a written cost and timeline impact before they are built, not after.

4. Is rework under control? If more than roughly 15% of hours go to redoing finished work, the leak is upstream in requirements and QA.

5. Are you building an MVP or a monument? If you are funding version-two features before version one has real users, the overpayment is in the scope, not the rate.

Score it honestly: four or five “yes” answers and your price is probably fair. Two or more “no” answers and it is worth getting an outside read before the next invoice.

What we learned shipping BrainCert on a bootstrapped budget

BrainCert is an EdTech platform we have built and scaled as the anchor engineering partner. The founders were bootstrapped, which meant every dollar had to earn its place — there was no VC cushion to absorb a bloated build. That constraint made them, and us, ruthless about where money went.

The discipline was exactly what this article describes: scope hard to what customers would pay for, sequence the work so nothing got built twice, and put QA in parallel so defects died young instead of shipping to production. No premium rates for routine work, no gold-plating ahead of demand. The money went to the features that drove revenue, and the rest waited.

The outcome: BrainCert reached roughly $3M in annual recurring revenue (2024, up 58% year over year), 100,000+ customers, and 500 million+ classroom minutes delivered — out-shipping venture-funded competitors on a fraction of their burn. Spending less and building more are not opposites. They are what happens when the hours go to the right work. Want a similar read on your build? A 30-minute call is enough to spot the biggest leaks.

When you are NOT overpaying

Sometimes the price is high because the work is genuinely hard, and paying it is the cheap option. Honesty cuts both ways, so here is when a big number is the right number.

You are not overpaying when you buy senior depth for genuinely hard problems — real-time video, HIPAA or SOC 2 compliance, high-concurrency systems — where a cheaper team would burn your budget on trial and error and still miss. You are not overpaying when discovery and QA look expensive on the invoice; those are the lines that keep the rework curve flat. And you are not overpaying when a solid team quotes more hours because they refuse to under-scope you into change-order territory later.

The tell is whether the money buys something you can point to: fewer bugs, faster delivery, a foundation that does not need rebuilding, compliance you can prove. Cost that maps to value is not overpayment — it is the whole reason to hire good people. Overpayment is cost with nothing on the other side of it.

KPIs: what to measure so you never overpay again

Feeling overcharged is a lagging signal. These three numbers turn it into a leading one, so you catch a leak in week two instead of month six.

Cost KPIs. Track effective cost per shipped feature (total spend divided by features actually delivered) and rework hours as a percentage of total. Rising cost-per-feature or rework above ~15% means hours are leaking, usually upstream.

Delivery KPIs. Track estimate-to-actual variance per milestone and change-order frequency. A team whose actuals hug their estimates and whose changes come with numbers is a team you can trust with an open-ended contract.

Quality KPIs. Track defects found in production versus in QA, and time-to-fix. When production defects climb, testing was cut — and you will pay for it on the rework curve. Cheap-looking QA is the most expensive thing to skip.

Get a second opinion before your next invoice

If you have read this far, you probably have a specific worry: a total that crept, a team that changed, a change order that stung. The fastest way to resolve it is an outside read from people who write these quotes for a living and have no stake in defending your current one.

That is a service we offer directly. Send us your quote, your last invoice, or the codebase itself, and we will tell you where the hours are going and whether the price is fair — through a code audit if the concern is quality, or a troubleshooting and optimization engagement if something is already on fire. If you decide to move the work, our dedicated development team model keeps the seniority you signed for on the project you signed it for.

And if the honest answer is that you are paying a fair price for good work, we will tell you that and send you on your way. A clear “you are fine” is worth the call too.

FAQ

How do you know if you are overpaying for software development?

Compare your effective rate (total divided by hours) to 2026 loaded ranges for your team's location: roughly $30-48/hr offshore, $55-88 mid-tier, $150-240 US senior. Then check the hours: if more than about 15% go to rework, or the vendor cannot itemize the estimate, you are likely overpaying on hours even if the rate looks fine.

How much does custom software development cost in 2026?

A focused MVP typically runs $40,000-$120,000, a production platform $120,000-$400,000, and enterprise systems higher. Cost equals hours times loaded rate, so scope and seniority drive the number far more than the headline rate. There is no single price for “an app,” any more than for “a building.”

Is a cheaper offshore team actually cheaper?

Only when the work is well-specified. Offshore headline rates are 40-70% below onshore, but load them at 1.4-1.8x for coordination and rework and the gap narrows fast. On ambiguous work, thin time-zone overlap and redo hours can make a cheap team cost more per shipped feature than a mid-tier one.

Should you use fixed price or time & materials to avoid overpaying?

Fixed price includes a risk premium and bills changes as extras, so on moving scope it usually costs more in total. Time & materials bills actual hours and tends to be cheaper for evolving products, at the cost of less upfront certainty. Fixed price wins only when scope is truly frozen.

What is a fair developer hourly rate?

There is no universal number, only ranges by region and seniority: about $30-48/hr loaded offshore, $55-88 mid-tier and senior Latin America, and $150-240 US senior in 2026. A rate is fair when it maps to the seniority and the hours delivered, which is why the hour breakdown matters more than the rate alone.

Can you lower your bill without changing vendors?

Often, yes. Trim scope to a real MVP, put a written impact estimate on every change, tighten requirements to cut rework, and reuse commodity components instead of building them. Those levers routinely cut a quote 30-50% without touching the rate. See the worked example above.

What are the biggest signs of an agency overcharging?

A firm fixed price with no scoping questions, a senior team in sales replaced by juniors after signing, no named owner for coordination, refusal to itemize hours, and change requests approved without a cost. Vague answers, not high numbers, are the reliable tell.

Is a code audit worth it if you suspect you are overpaying?

Usually. An independent code audit finds where quality and money are leaking (rework-prone code, missing tests, shaky architecture) and gives you an outside read on whether the hours you are billed match the work delivered. It is the fastest way to turn a vague worry into specific numbers.
