Software project expectations versus reality gap between initial plans and actual development outcomes

Key takeaways

The gap is usually process, not talent. Most software development expectations vs reality mismatches trace back to fuzzy requirements and thin communication, not bad engineers.

Four fixes close most of it. A testable spec, visible progress, real change control, and layered testing realign the vast majority of drifting projects.

Waiting is the expensive option. A defect that costs 1× to fix at the spec stage costs 60–100× in production (IBM). Catch drift early.

Diagnose before you switch vendors. Run the four fixes for 4–6 weeks first; a code audit tells you if the partner or the process is the problem.

Scope creep is the silent killer. 52% of projects hit scope creep (PMI, 2018). A written change-control loop is your cheapest insurance.

Software development expectations vs reality is the gap every project owner dreads: you signed off on a vision, and what came back doesn't match it. Screens feel off, features behave oddly, the timeline slipped, and nobody can tell you exactly why. The good news, after 20 years of shipping products at Fora Soft, is that this gap is almost always a process problem, not a talent problem — and process problems are fixable without burning the project down.

This is a project owner's playbook, not a developer's. It shows you how to diagnose the drift in an afternoon, close it with four concrete fixes you can start this week, run the math on what waiting costs, and decide — with a clear head and a checklist — whether your current team can get you there. We wrote it from the client's chair on purpose, because that's where the hard calls actually get made.

Why your software drifted from the vision

Software drifts from the vision because the vision lived in your head, not on paper, and everyone downstream filled the blanks with their own assumptions. A developer reads "make checkout simple," pictures one flow; you pictured another; QA tests a third. Nobody lied and nobody slacked — the spec just wasn't specific enough to keep three brains in sync over six months.

Three forces widen that first small gap. Requirements that were never written down as testable statements. Weeks where you couldn't see working software, so small misunderstandings compounded silently. And a steady trickle of "quick" changes that nobody priced, which quietly rewrote the plan. Each one is ordinary. Stacked across a project, they're why the demo surprises you.

We've watched this pattern across 250+ projects since 2005, with a team of 50 in-house engineers and a 100% success rate on Upwork. The projects that stayed aligned weren't staffed by smarter people. They ran a tighter loop: write it down, show it early, price every change, test against the spec. That loop is the whole article. If you'd rather have us run it on your project, our custom software development team does exactly this.

How common is this gap, really?

Very common. The majority of software projects miss on time, budget, or scope. The Standish Group CHAOS research, drawn from a database of 50,000+ projects, put only 31% of projects in the "successful" bucket (on time, on budget, full feature set) in its 2020 report; 50% were "challenged" and 19% failed outright. So if your project feels off, you're in the majority, not the exception.

The bigger the project, the wider the gap tends to be. A McKinsey study with the University of Oxford of 5,400+ large IT projects (2012) found they ran, on average, 45% over budget and 7% over schedule while delivering 56% less value than predicted. Standish's own cut of the data shows small projects succeeding around 90% of the time and very large ones under 10% — a strong argument for shipping in smaller, verifiable slices.

Here's the part that should encourage you: the root causes are boring and fixable. They cluster around requirements, communication, and change management, the three things a project owner can actually influence without writing a line of code.

Relative cost to fix a software defect by phase: 1x design, 6.5x build, 15x test, 60-100x production (IBM)

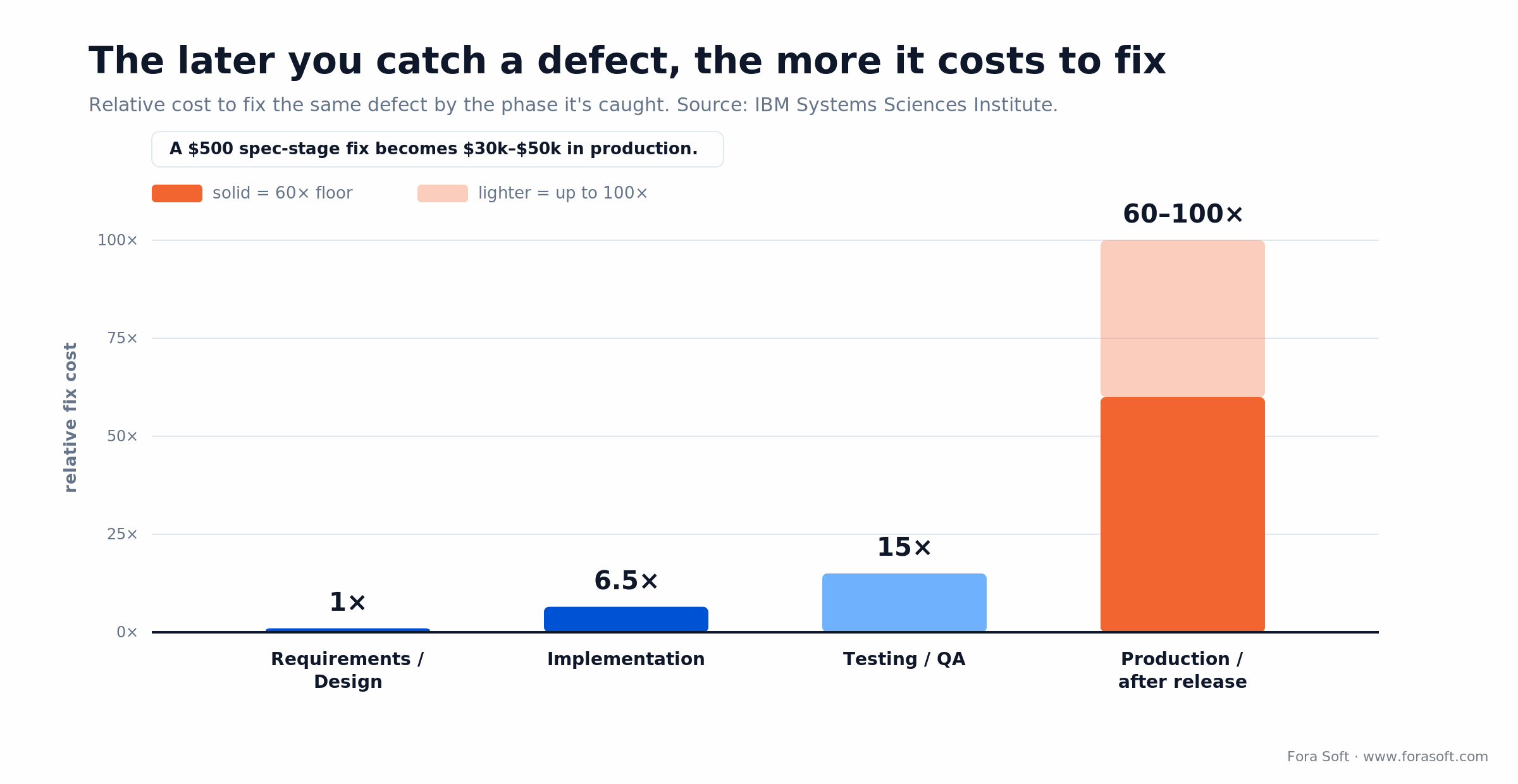

Figure 1. The same defect gets 60–100× more expensive to fix once it reaches production — the case for catching drift early.

Diagnose the gap before you assign blame

Before you email the vendor an angry list, spend an hour sorting the gap into four buckets. The fix, and whether the vendor is even at fault, depends entirely on which bucket you're in.

1. Requirements gap. The software does what was written, but what was written wasn't what you meant. This is the most common case, and it's usually shared blame: the spec was ambiguous and nobody flagged it. Fix by rewriting requirements as testable statements (section below).

2. Communication gap. The team knew the right thing to build but you found out too late that they'd gone sideways. You hadn't seen working software in weeks. Fix by forcing visible progress: demos every 1–2 weeks, one written status per week.

3. Scope gap. You keep adding "small" things, and each one pushed the timeline without anyone re-quoting it. This one is often the owner's own doing. Fix with a change-control loop that prices every request.

4. Quality gap. The features exist but break under real use. Bugs reach you instead of the test suite. Fix by layering unit, integration, and acceptance testing, and by reading our guide on too many bugs in a software project.

Most stalled projects are a blend, but one bucket usually dominates. Name it out loud before you act. Blaming a communication gap with a testing fix just wastes another sprint.

Reach for a full audit when: two or more buckets are red at once, or you can't tell which bucket you're in after an honest hour. A structured code audit turns a vague "it feels wrong" into a ranked list.

Not sure which gap you're in?

Send us the project and we'll run a free 30-minute triage: which bucket is red, and what the cheapest fix looks like.

Book a 30-min call → WhatsApp → Email us →

Fix 1: Turn fuzzy requirements into a blueprint

A requirement is done when a stranger could test it without asking you a question. That's the bar. "The app should be user-friendly" fails it; "first-time users complete signup in under 30 seconds, with no more than two form errors" passes it. The second version can be built to, tested against, and argued about before code exists — which is exactly where arguments are cheap.

Requirements-stage clarity is the highest-return hour you'll spend. It's where the CHAOS data keeps pointing: incomplete requirements and weak user involvement top the failure factors year after year. And it's where Figure 1 bites — a misread caught in a spec review costs a sentence to fix; the same misread caught after launch costs a release.

Write user stories a stranger could test

Frame each requirement as "As a [role], I want [action] so that [outcome]," then add acceptance criteria: the specific, checkable conditions that mean "done." Acceptance criteria are the contract between your intent and their code. If you can't write them, the requirement isn't ready, and building it is a coin flip. Our walkthrough of the analytical stage of software development shows how we structure this before a sprint starts.

Document like you'll onboard a stranger tomorrow

Good documentation isn't bureaucracy; it's the thing that lets a new engineer read the intent instead of guessing it. We hold ourselves to that standard publicly — our engineering Learn library documents how we build complex video systems, block by block. Ask your team where the equivalent lives for your product. If the answer is "in Slack," that's a finding.

Reach for a discovery sprint when: you're more than a week into disagreement about what a feature should do. One to two weeks of structured spec work is cheaper than one wrong month of building, every time.

See it before you build it

Wireframes and clickable prototypes are the cheapest place to be wrong. A prototype lets you and every user role walk the flows — signup, checkout, admin — before a single component is coded. Spotting a confusing checkout on a wireframe costs an afternoon of redraw; spotting it in production costs a re-architecture and an incident.

Put real users, or people who behave like them, in front of the prototype early. Their confusion is data, and it's data you want now, not after launch reviews. Our wireframing guide covers how to run these sessions without over-investing in pixel-perfect mockups too soon.

One caution: a prototype is a map, not the territory. It validates flow and intent, not performance or edge cases. Sign off on the prototype, then keep the acceptance criteria from Fix 1 as the real definition of done. The picture and the checklist do different jobs.

Fix 2: Make progress impossible to hide

You close a communication gap by making working software visible on a fixed cadence, so a wrong turn shows up in days, not months. Two rituals do most of the work: a short written status every week, and a live demo of running software every one to two weeks. If you can't see it run, assume you don't know where it is.

Weekly written status. Three lines: what shipped, what's next, what's blocked. Written, not verbal. A paper trail catches drift that a cheerful standup hides. It also gives you something to compare against last week, which is where slippage first becomes visible.

Demos of real software, every 1–2 weeks. Not slides, not screenshots — the actual build, clicked through live. This is the single highest-signal habit in the article. The Agile Manifesto put "working software" at the center for a reason; the 2001 manifesto still reads like a checklist for avoiding exactly this gap.

One throat to choke. Name a single person on the vendor side who owns your outcome, usually a project manager or a customer success manager. Diffuse ownership is how "everyone thought someone else was handling it" happens. For startups running lean, this matters double: you're wearing five hats, and the one you can safely hand off is status-chasing.

Reach for a cadence reset when: your last three updates were verbal and optimistic, and you haven't clicked through a live build in three weeks. Silence is not the same as progress. It's just quieter risk.

Change-control loop: log request, assess time cost scope, sign off, re-baseline and verify; declined items parked

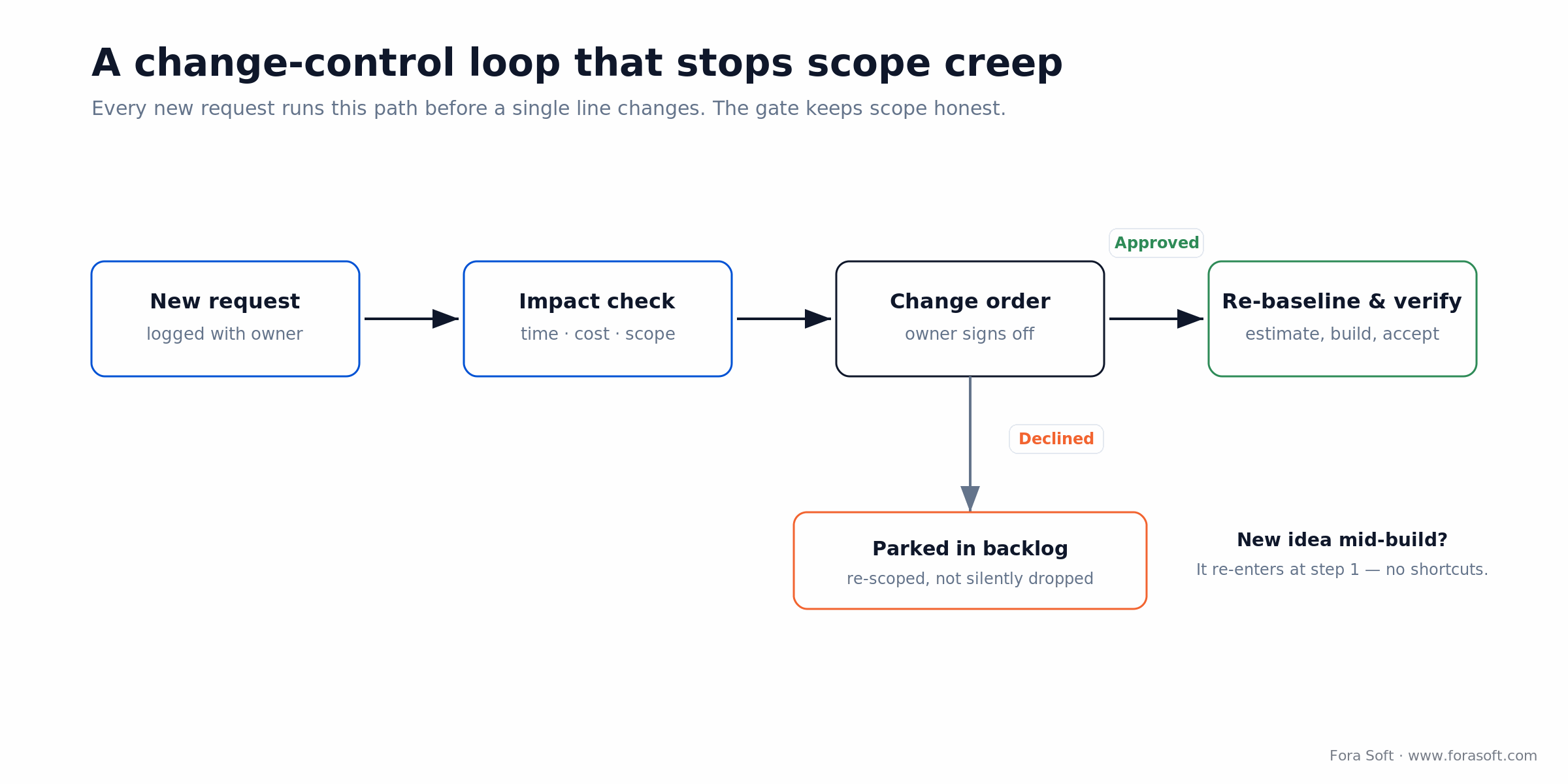

Figure 2. Every change request runs the same loop before code moves — the mechanism behind Fix 3.

Fix 3: Change control that stops scope creep

Change control is a simple rule: no change gets built until someone has priced its impact on time, cost, and scope, and you've signed off on that price. It sounds bureaucratic. It's the opposite: it's what lets you say yes to changes without lying to yourself about the timeline.

Scope creep is not a fringe risk. PMI's Pulse of the Profession (2018) found 52% of projects experienced scope creep, up from 43% five years earlier. The teams that kept it low didn't say no to everything. They priced everything. That's the whole trick.

Figure 2 shows the loop we run. A request gets logged with an owner. Someone assesses the hit to time, cost, and scope. You approve or decline. Approved work gets a re-baselined estimate before anyone starts; declined work goes to the backlog, re-scoped, not silently dropped. New idea mid-build? It re-enters at step one. No shortcuts — that's the point.

The owner-side discipline here is yours, not the vendor's. Every "while you're in there, could you also…" is a change request. Treat it like one. If you suspect you've been on the paying end of unpriced scope, our take on feeling like you're overpaying for development is a useful companion read.

Reach for strict change control when: your feature list has grown since kickoff but your deadline hasn't moved. That combination is not optimism. It's an unfunded promise waiting to slip.

Watching scope creep eat your timeline?

We'll set up a change-control loop and a demo cadence on your project in the first week — and show you where the current plan is leaking.

Book a 30-min call → WhatsApp → Email us →

Fix 4: Testing that proves it matches the spec

Testing isn't only bug-hunting. It's the proof that the software does what the acceptance criteria said it would. Three layers stack to give you that proof, and each answers a different question.

Unit tests ask "does each part work in isolation?" Integration tests ask "do the parts work together?" Acceptance tests ask the only question you care about: "does it meet the requirements we signed?" Acceptance tests are your requirements from Fix 1, made executable. If they pass, the reality-versus-expectation gap is closed by definition, not by opinion.

Automate what's stable and repetitive so regressions get caught the moment they appear, but keep humans on usability and edge cases — automation doesn't notice that a flow is confusing. Our piece on the importance of testing and our approach to testing at every stage go deeper on the mix.

Ask your team one question this week: "which acceptance tests cover the feature that surprised me?" If the answer is "none," you found the gap. Testing that maps to signed requirements is how you keep software reliable instead of hoping.

After launch: triage, hotfix, root fix

Launch is not the end of the reality gap. It's where real users find the parts your tests missed. A defect-management routine keeps small issues from becoming the next expectations crisis. Four habits carry most of the load.

Triage by real impact. Rank incoming bugs by severity and blast radius, with support, engineering, and product in the room. Not every bug is urgent; a crash on checkout outranks a typo, and treating them the same burns your team out on the wrong things.

Hotfix, then root-fix. Use a fast patch to stop the bleeding, but always schedule the real fix. Ship a hotfix and call it done, and the same defect comes back wearing a different hat next month.

Price out-of-cycle releases. Decide emergency releases on customer impact, and make the cost visible to the team: interrupts aren't free. Then add monitoring so the next occurrence pages you before a user tweets about it, and confirm tentative fixes actually held.

Is the gap fixable with your current vendor?

Usually yes — if the team has the four fixes in them and just wasn't running them. The way to find out is to install the fixes and watch, not to switch on a bad week. Figure 3 is the decision spine we use: each "no" points to a concrete fix before switching vendors ever enters the conversation.

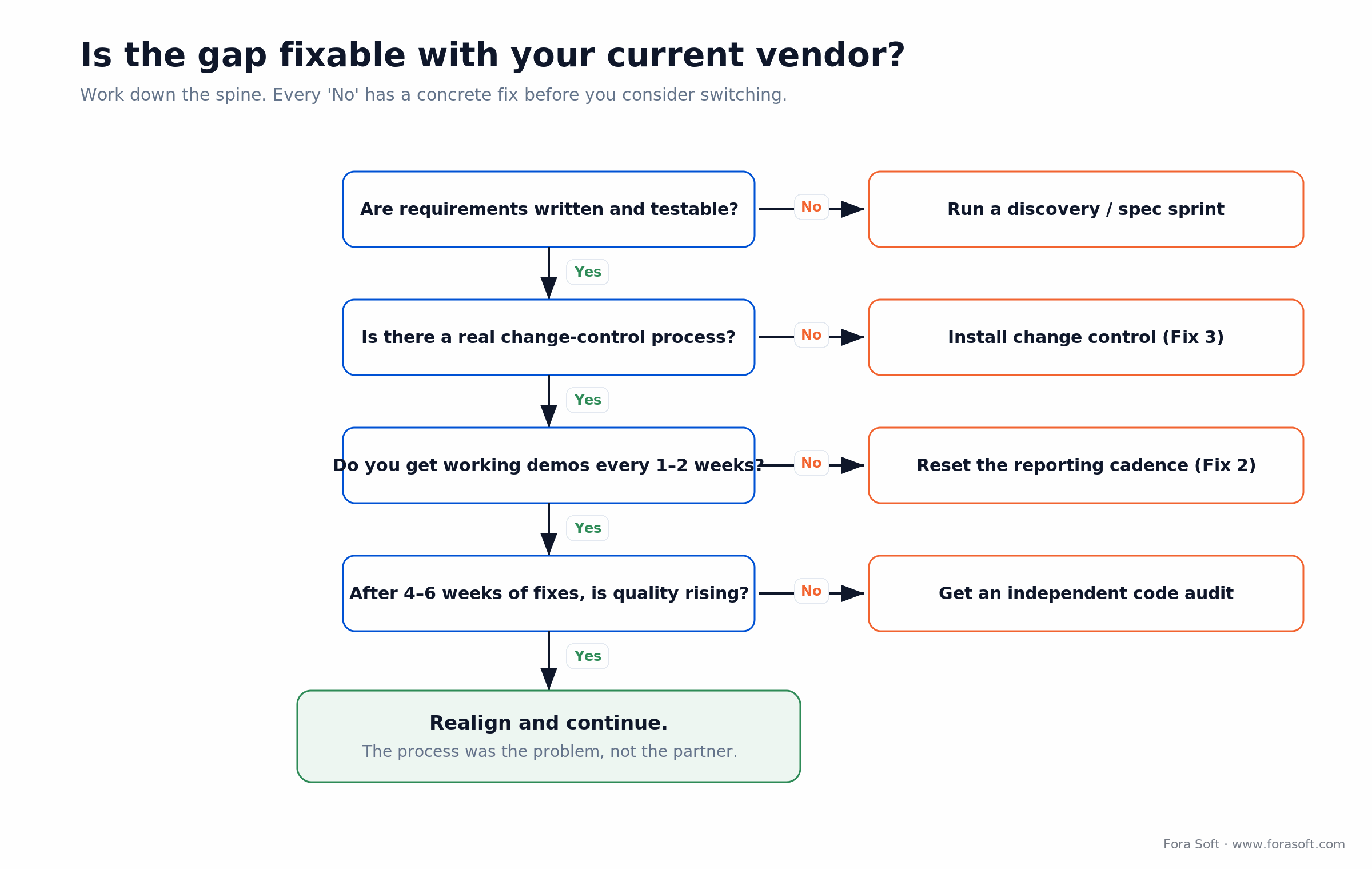

Decision tree: is the software gap fixable with your current vendor, from testable requirements to a code audit

Figure 3. Work down the spine. Only after every fix is in place and quality still isn't rising does switching make sense.

The order matters. Fixing requirements before communication before change control means each step removes a variable, so by the time you're at "is quality rising after 4–6 weeks," you're measuring the team, not the mess around them. If quality climbs, the process was the problem and you just kept your institutional knowledge. If it doesn't, you now have evidence, not a hunch, and a switch is defensible.

The last "no" points to an independent code audit for a reason: a second set of eyes on the codebase tells you whether the foundation is sound or whether you're polishing something that needs rebuilding. That's a fact you want before you spend switching costs.

Realign, re-scope, or replace

Once you've diagnosed the gap, you have five realistic moves, from cheapest to most drastic. Most owners jump straight to "replace" when "realign" would have worked in a fortnight. Here's how they compare on the axes that actually decide it.

Move Best when Time to signal Cost & risk When it's wrong
Realign in place One or two gaps, willing team 2–4 weeks Lowest Team won't adopt the process
Re-scope the plan Timeline broke, budget didn't 1–2 weeks Low The real problem is quality
Add a co-pilot team Capacity or skill gap, not intent 2–3 weeks Medium Two teams, no clear owner
Independent code audit You can't tell if code is sound 1–2 weeks Low Used to stall a needed decision
Replace the vendor Fixes ran, quality still flat 6–12 weeks Highest Done on emotion, not evidence

Reach for "replace" only when: you've run the four fixes for at least a month, quality is still flat, and an audit confirms the code — not the process — is the ceiling. Anything earlier is an expensive way to reset the same problem.

Need a second opinion before you switch?

A Fora Soft code audit tells you whether your foundation is sound — a ranked report with fix estimates, not a sales pitch to rebuild.

Book a 30-min call → WhatsApp → Email us →

Mini-case: two years of exceeded expectations

When BrainCert came to us, the goal was ambitious: a WebRTC-and-HTML5 virtual classroom competing with VC-backed giants across a $400B+ e-learning market, built by a lean team. The kind of project where expectations and reality drift fast if the loop is loose.

The plan was the four fixes, run relentlessly. Testable requirements before each build. Working demos on a fixed cadence. Every feature request priced against time and scope. Layered testing tied to acceptance criteria, backed by compliance work (SOC 2, ISO 27001, HIPAA, GDPR) where the market demanded it. Nothing exotic: the same loop this article describes, applied for years, not a sprint.

The outcome: BrainCert reached $3M in annual revenue in 2024 (58% year-over-year growth, up from $1.9M in 2023), 100K+ customers, and 500M+ real-time classroom minutes at 99.995% uptime — bootstrapped, no outside funding. After two years the CEO's summary was blunt: “Their work is outstanding in every aspect — from technical architecture to programming. Our latest feature update exceeded my expectations once again.” Expectations exceeded, not merely met, is the target. Want a similar assessment of your project? Book a scoping call.

The cost of waiting, in real numbers

Waiting to close an expectations gap gets exponentially more expensive, and the math is worth doing out loud. The IBM Systems Sciences Institute multipliers (Figure 1) are a widely-cited industry benchmark: a defect costs about 1× to fix at design, 6.5× at implementation, 15× at testing, and 60–100× once it's in production.

Put money on it. Say a misunderstood requirement would take four hours to fix at the spec stage, call it $500 of engineering time. Caught in production, the same misunderstanding runs 60–100×: $30,000 to $50,000, once you count re-coding, re-testing, redeploying, the incident, customer comms, and the secondary bugs the fix introduces. One misread requirement. That's the price of finding out late.

Now scale it. NIST's 2002 study, The Economic Impacts of Inadequate Infrastructure for Software Testing, estimated inadequate testing cost the US economy roughly $59.5B a year, with more than a third recoverable through earlier detection. The pattern holds from one requirement to a whole economy: the fix is always cheaper the earlier you catch it. Every fix in this article is really a way to catch drift on the cheap side of that curve.

A decision framework in five questions

When the gap feels overwhelming, answer these five questions in order. They convert a vague dread into a specific next action.

1. Can you write the acceptance test for the feature that disappointed you? If no, you have a requirements gap. Start there. Everything downstream inherits this ambiguity.

2. When did you last click through the real, running build? If it's been more than two weeks, you have a communication gap. Fix the cadence before you judge the work.

3. Has the feature list grown while the deadline stayed put? If yes, you have a scope gap. Install change control this week.

4. Are bugs reaching you instead of the test suite? If yes, you have a quality gap. Layer the testing and tie it to acceptance criteria.

5. After 4–6 weeks of fixes, is quality visibly rising? If yes, keep going, the process was the issue. If no, get an audit and weigh a switch on evidence. That's the moment a change of partner is a decision, not a reaction.

Five pitfalls that widen the gap

1. Treating a demo as a status report. A confident verbal update is not evidence. Only running software clicked through in front of you counts. Slides hide drift; builds expose it.

2. Approving changes without pricing them. "Just a small tweak" is how timelines die by a thousand cuts. Every change gets an impact estimate before a yes, no exceptions for friendly ones.

3. Switching vendors on a bad week. A switch mid-project resets institutional knowledge to zero and often reproduces the same gap with new faces. Run the fixes first; switch on evidence.

4. Confusing "on schedule" with "on track." A project can hit dates while building the wrong thing. Acceptance tests, not calendar progress, tell you if reality matches the spec.

5. Skipping the spec to "save time." The week you don't spend writing testable requirements is borrowed at 60–100× interest, payable in production. It's the most expensive shortcut in software.

When the vendor is not the problem

Sometimes the honest answer is that the gap starts on your side of the table, and no new vendor will fix it. Say so out loud — it's the fastest path to a project that works.

If requirements changed every week because the market kept teaching you something new, that's not the team failing, but a discovery problem, and the answer is a tighter change-control loop, not a firing. If demos happened and you didn't attend, the visibility was there and the process broke on your end. If the budget assumed a scope that was never realistic, re-scoping beats blaming. And if the timeline was set before anyone wrote a spec, the estimate was fiction from day one; our note on missed deadlines covers how to reset one honestly.

This honesty is not self-flagellation. It's an advantage. Every cause that lives on your side is one you can fix immediately, without switching costs. A good partner will tell you which gaps are theirs and which are yours. If yours never come up in the conversation, that itself is a signal about the partner.

Metrics that keep expectations aligned

Once the gap is closed, three buckets of metrics keep it closed. Track one number in each and you'll see drift weeks before it becomes a crisis.

Alignment KPIs. Percentage of shipped features with signed acceptance criteria (target: 100%), and requirement-change rate per sprint. A spike in changes with no timeline change is scope creep forming.

Quality KPIs. Escaped-defect rate (bugs found by users versus tests), and mean time to fix. If users find more than your test suite does, the testing layer is too thin.

Predictability KPIs. Sprint commitment versus delivery, and how early a slip is visible. A healthy project surfaces slippage weeks ahead; a drifting one surprises you at the deadline. See Figure 4 for the before-and-after this produces.

Before and after: a drifting software project vs the same scope aligned by requirements, demos, change control, tests

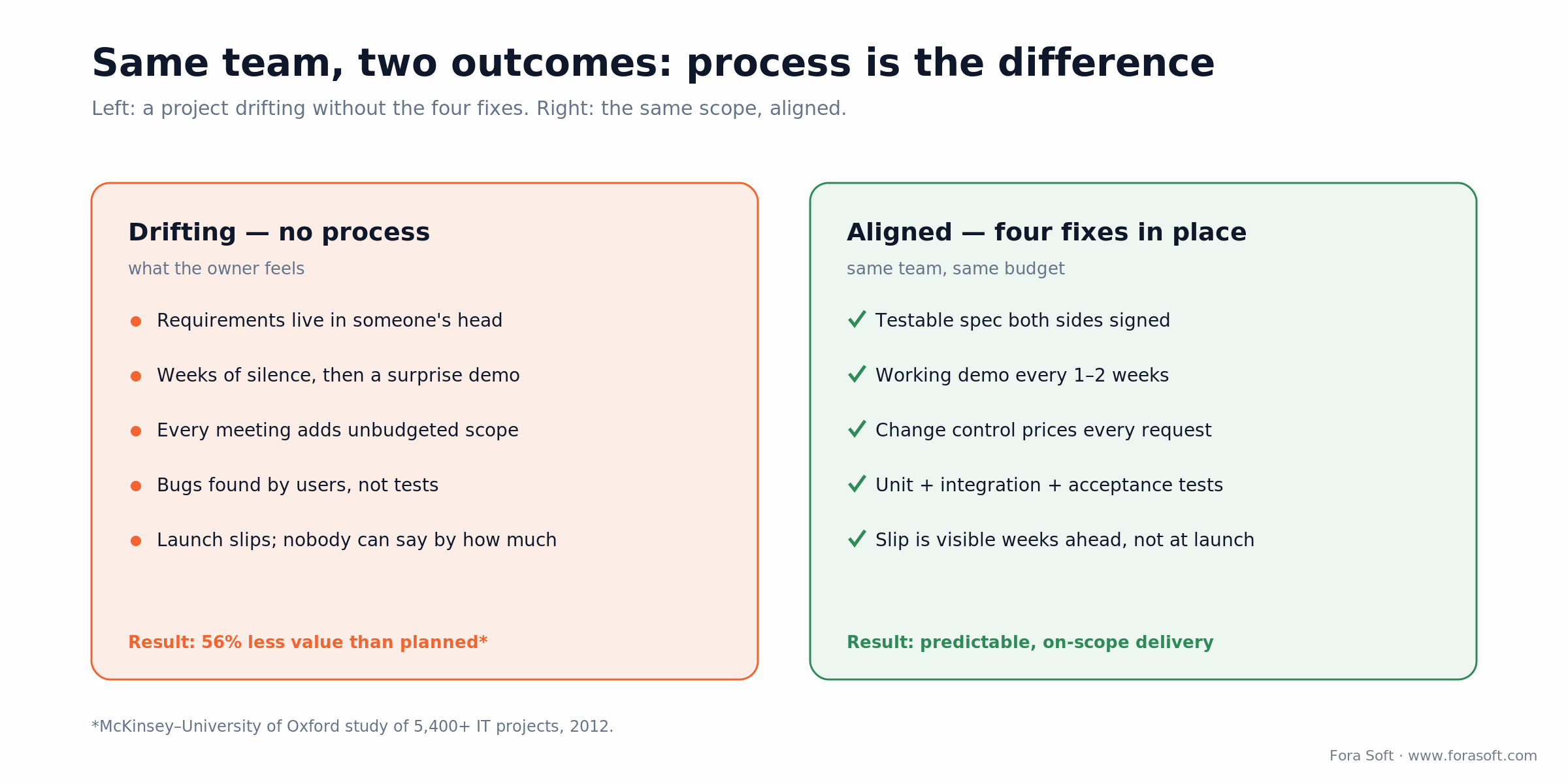

Figure 4. Same team, same budget — the four fixes are the difference between drift and predictable delivery.

FAQ

Why does my software never match what I expected?

Almost always because the expectation lived in your head instead of on paper as testable requirements. Downstream, developers, testers, and you each fill the gaps with different assumptions. Writing acceptance criteria before building removes the ambiguity that causes the drift.

Should I fire my software vendor if the project is off track?

Not yet. Run four fixes first: testable requirements, demos every 1–2 weeks, change control, and layered testing — for 4–6 weeks. If quality rises, the process was the problem and you keep your team's knowledge. If it stays flat after an audit, switching is then a decision backed by evidence.

How common is it for software projects to miss expectations?

Very common. The Standish Group CHAOS 2020 report classed only 31% of projects as fully successful, with 50% challenged and 19% failed. Large projects fare worse: a McKinsey–Oxford study found they averaged 45% over budget and 56% less value than predicted.

What is scope creep and how do I stop it?

Scope creep is the steady addition of "small" features that quietly push the timeline because nobody re-priced them. PMI found 52% of projects hit it in 2018. Stop it with change control: every request gets an impact estimate on time, cost, and scope, and a sign-off, before any code moves.

How often should I see a working demo?

Every one to two weeks, of the real running build — not slides or screenshots. Live demos are the highest-signal habit for catching drift early. If you haven't clicked through working software in three weeks, treat that silence as risk, not progress.

What does it cost to fix a defect late instead of early?

Per the IBM Systems Sciences Institute, a defect costs roughly 1× at design, 6.5× at implementation, 15× at testing, and 60–100× in production. A $500 spec-stage fix can become $30,000–$50,000 once it ships, counting re-work, re-testing, and the incident.

Is a fixed-price or time-and-materials contract better for avoiding this?

Neither prevents an expectations gap on its own. The process does. Fixed-price pushes teams to freeze scope early, which helps requirements but punishes change; time-and-materials flexes with change but needs strict change control to stay honest. Pick the model, then run the four fixes regardless.

What is a code audit and when do I need one?

A code audit is an independent review of your codebase that ranks issues by severity and estimates fixes. Get one when two or more gaps are red at once, or before switching vendors — it tells you whether the foundation is sound or whether you'd be rebuilding either way.
