A software project rescue starts the moment you stop believing the next status update. The demo slips again, “almost done” has meant almost done for a month, and the release date is a moving target nobody defends anymore. That drift is expensive: McKinsey and Oxford, studying 5,400 large IT projects (2012), found they run 45% over budget and 7% over schedule while delivering 56% less value than promised. Most of that damage is avoidable if you act on the right signals early.
We’re Fora Soft. We’ve shipped 250+ software products since 2005, and a fair number of them came to us already on fire — half-built, late, and handed over by a team that had run out of road. This is the playbook we actually use to turn a slipping project around: how to read the warning signs, decide whether to rescue or rebuild, run the audit, and get to a date you can trust. No blame, no jargon, just the moves that work.
Key takeaways
• Missed deadlines are a symptom, not the disease. The usual root causes are unclear scope, weak testing, and drifting communication. Fix those and the dates stop moving.
• Do not throw more developers at a late project. Brooks’s Law is real: ramp-up and coordination make a late project later. Cut scope before you add people.
• Audit before you decide. A one- to two-week code and delivery audit tells you whether to rescue in place, rebuild behind a strangler, or restart honestly.
• Secure the code, repos, and IP on day one. No access, no rescue. Ownership, credentials, and knowledge transfer are the first thing a serious partner locks down.
• A rescue has a shape. Stabilize, audit, re-plan, execute in weekly demos, then prevent. Twelve weeks is a realistic target for most stuck builds.
Why Fora Soft wrote this rescue playbook
We didn’t learn this from a webinar. We learned it by inheriting other people’s unfinished software and getting it to production. Over 20 years and 250+ projects, our 50 in-house engineers have taken over codebases with no tests, no docs, and one exhausted developer who owned every secret in their head. Some we rescued in place. A few we told the client to restart, because that was the honest answer.
That mix of experience is the point. A rescue partner who only ever says “yes, we can save it” is selling you hours, not judgment. We’ve done full-scale takeovers like BrainCert, an education platform we grew to 100K+ customers and 500M+ delivered classroom minutes, and we’ve stabilized live healthcare products like CirrusMED under HIPAA constraints. When we say a project is salvageable, it’s because we’ve scored the code, not because we want the contract.
This guide is deliberately vendor-neutral. Most of it applies whether you hire us, hire someone else, or fix it with your own team. If you want a second opinion on your specific situation, our software troubleshooting and optimization team runs these audits every week.
Is your project quietly slipping?
Book a free 30-minute call. We’ll tell you honestly whether it needs a nudge, an audit, or a rescue — no pitch.
What to do first when deadlines keep slipping
The short answer: stop, measure, and cut — in that order. Before you add people or promise a new date, freeze scope for one week, get an honest picture of what actually works, and reduce the plan to something believable. Panic makes late projects later; a calm reset is what turns them around.
Here are the first five moves, and none of them is “code faster”:
- Freeze the scope for a week. No new features, no “small” additions. You cannot measure a moving target.
- Get a working build you can click. If nobody can demo the product today, that’s your real status, not the task board.
- Write down the actual state. What works, what’s half-done, what’s untested. Facts, not adjectives.
- Find the single points of failure. If one person owns all the knowledge, that’s the first risk to retire.
- Re-baseline to a believable date. Cut to a real MVP and re-plan from evidence.
Do these five and you’ve already done more than most teams do in a month of stand-ups. The rest of this guide is how to go deeper on each one.
Signs your software project needs rescue
A project rarely fails overnight. It sends signals for weeks first. The trick is telling a rough patch (fixable with a conversation) from a structural problem (fixable only with an audit and a reset). Score yourself against the eight signs below: three or more reds and the project will not right itself without intervention.

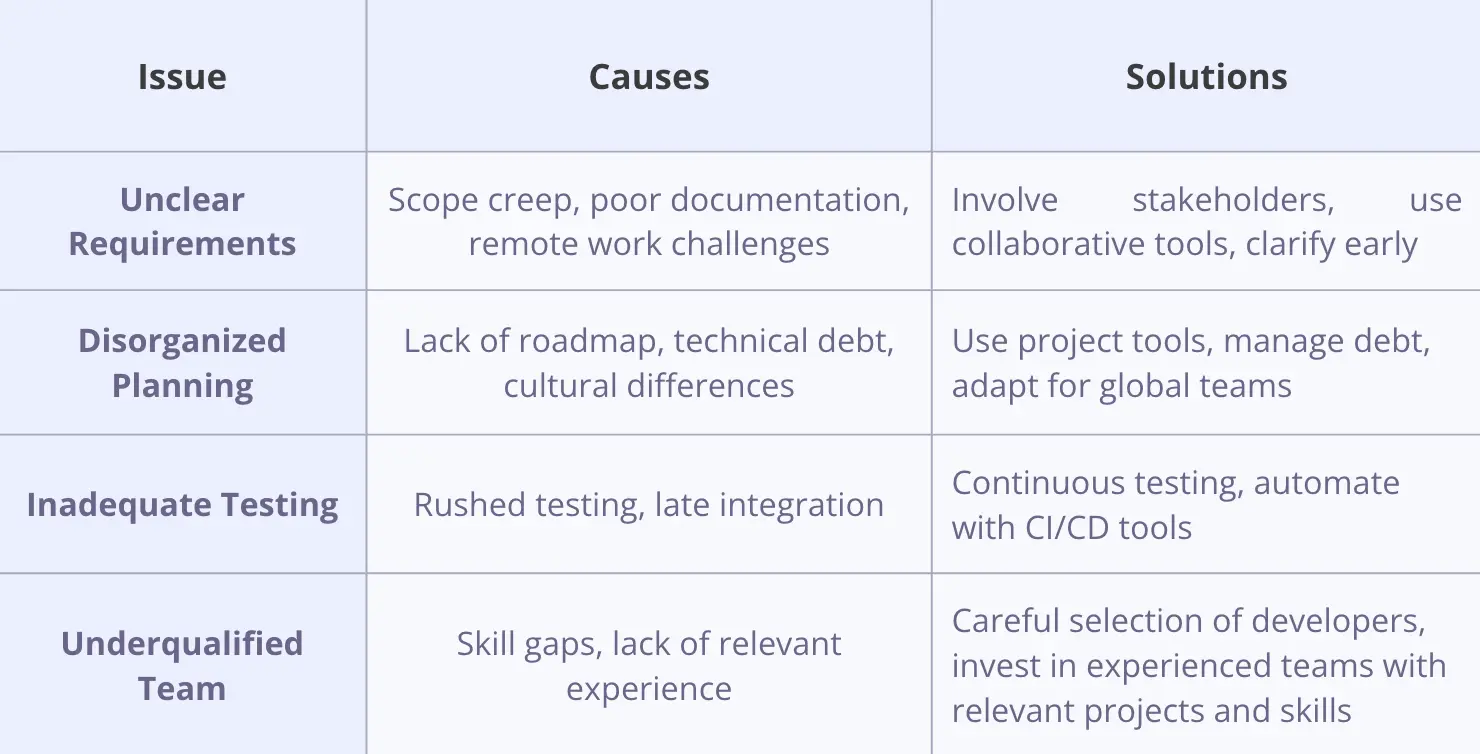

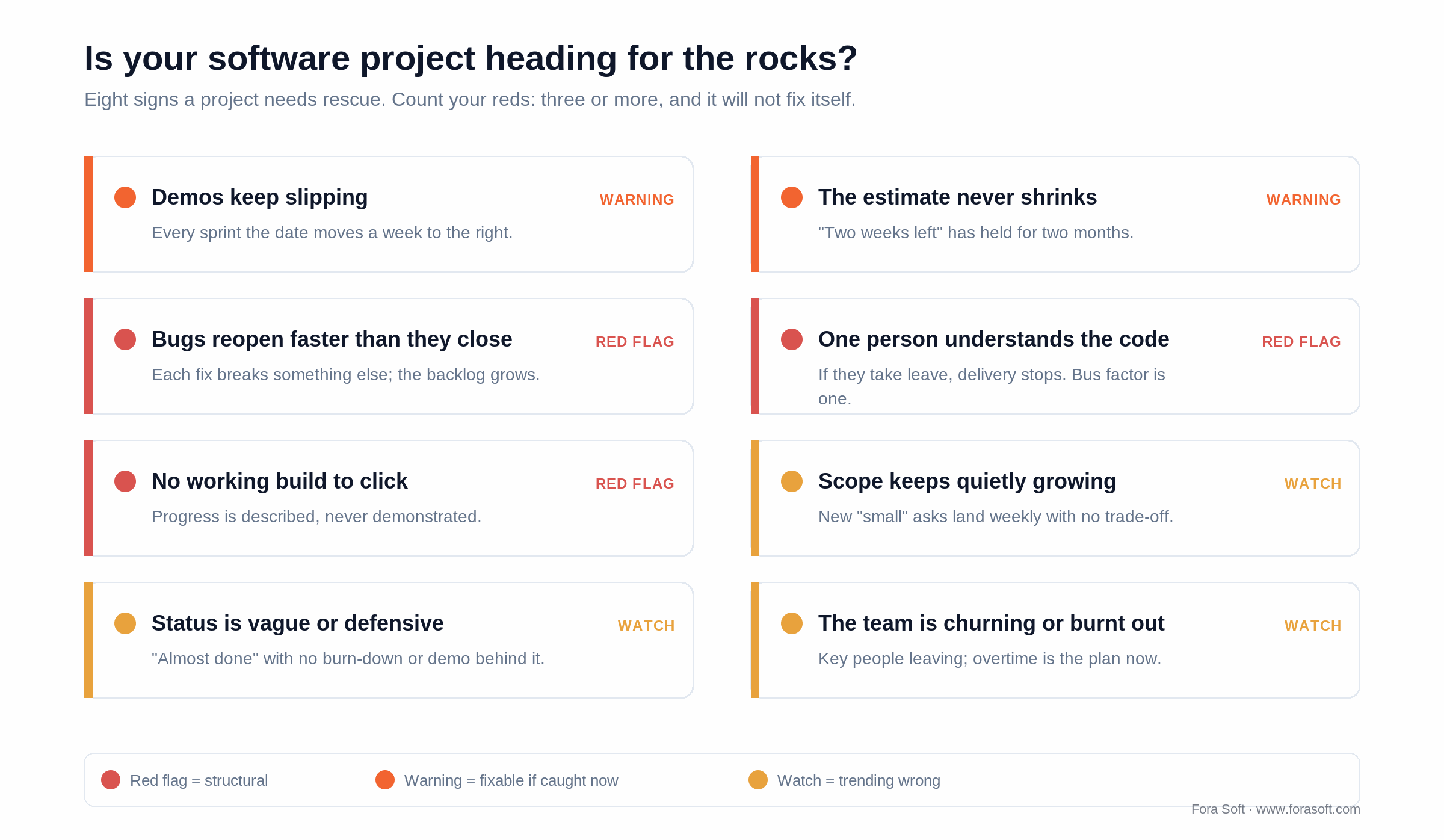

Figure 1. Eight warning signs, scored watch / warning / red flag. Count your reds — three or more means it will not fix itself.
The structural red flags. Bugs that reopen faster than they close mean the codebase has no safety net. A bus factor of one — only one person understands the code — means delivery stops the day they take leave. No working build to click means “progress” exists only in conversation. Any of these three is a reason to run a code audit now.
The softer warnings. Estimates that never shrink, scope that keeps quietly growing, defensive status updates, and a burnt-out or churning team are all fixable if you catch them this quarter. Left alone, they harden into the red flags above. The point of scoring is to act while the fix is still cheap.
Reach for a rescue when: you count three or more reds, the release date has moved twice with no structural change, or you can’t get a working demo on demand. One or two ambers is a coaching problem, not a rescue.
Why software projects run late in the first place
Late delivery almost always traces back to the same handful of causes. Name yours before you fix anything — the cure depends on the disease. In our experience across 250+ builds, five causes account for the large majority of slippage.
1. Unclear or moving requirements. When goals and edge cases aren’t pinned down, new demands surface mid-build and force rework. This is the most common and most expensive cause, and it’s why we treat the analysis stage as non-negotiable.
2. Disorganized planning. Without milestones, dependencies, and realistic estimates, developers start coding before designs are ready and testers wait on builds that never come. Good estimation is a skill, and skipping it guarantees surprises.
3. Testing bolted on at the end. If testing starts late, defects hide until they’re expensive to fix. Deferred bug-fixing is a debt that comes due right before launch, at the worst possible time.
4. Technical debt. Shortcuts taken to hit an early date accrue interest. Each quick fix makes the next change slower, until a one-day task takes a week. Unmanaged legacy code is a schedule killer disguised as working software.
5. An under-skilled or mis-managed team. Talented people on the wrong problem, or a strong team with no project manager to sequence the work, both produce the same result: motion without progress.
Why software is uniquely risky (the data)
If your project is late, you are not an outlier. Software is the riskiest kind of project there is, and the research is blunt about it. Knowing the base rates helps you set expectations with stakeholders and justify the reset.
A 2026 study by Bent Flyvbjerg and colleagues compared 23 types of projects and found IT has the fattest tail of all of them: it’s the only category whose cost overruns are, statistically, effectively unbounded. Define the tail as any overrun above 50%, and 18% of IT projects land there; in that tail the overruns are extreme, with a conditional average around 450%, worse than building nuclear waste storage. Software doesn’t just fail more, it fails bigger.
The classic numbers agree. Flyvbjerg and Budzier’s Harvard Business Review study (2011) of 1,471 IT projects found an average cost overrun of 27%, but one in six was a “black swan” that overran by 200% on cost and 70% on schedule. The Standish CHAOS data has long put fully successful projects at roughly a third. The full analysis is worth reading if you need to convince a board.
Reach for the data when: a stakeholder treats the delay as a moral failure of the team. It’s not personal — it’s the base rate for software. What matters is responding to it well, which is the rest of this guide.
The trap that makes it later: adding developers
The most tempting move when a project is late is also the most reliable way to make it later. Adding developers to a late software project delays it further. This isn’t an opinion; it’s Brooks’s Law, from Fred Brooks’ 1975 classic The Mythical Man-Month, and it holds up every time we watch a client try the opposite.

Figure 2. Add people past a point and the ship date moves out, because coordination paths grow as n(n−1)/2 — not because the new hands are lazy.
The math is unforgiving. Communication channels grow as n(n−1)/2. A team of 5 has 10 channels; grow it to 10 and you have 45; push to 12 and it’s 66. Every new person also needs weeks to learn the codebase, and the person teaching them stops shipping while they do it. On a healthy project that cost pays off later. On a late one, you don’t have “later.”
The fix runs the other way. Shrink the scope, not the crowd. Cut to the smallest thing that’s genuinely shippable, keep the team small and senior, and add people only once the codebase is stable and the work actually divides. A tight team of five that owns the code will out-deliver a panicked team of twelve every time.
Rescue, refactor, rewrite, or restart?
The biggest decision in any software project rescue is what to do with the existing code. Rescue it in place, rebuild it incrementally, rewrite it from scratch, or stop entirely. Get this wrong in either direction and you burn money: rewriting salvageable code wastes months, while patching a broken foundation wastes everything. Walk the questions in order and take the first honest “no.”

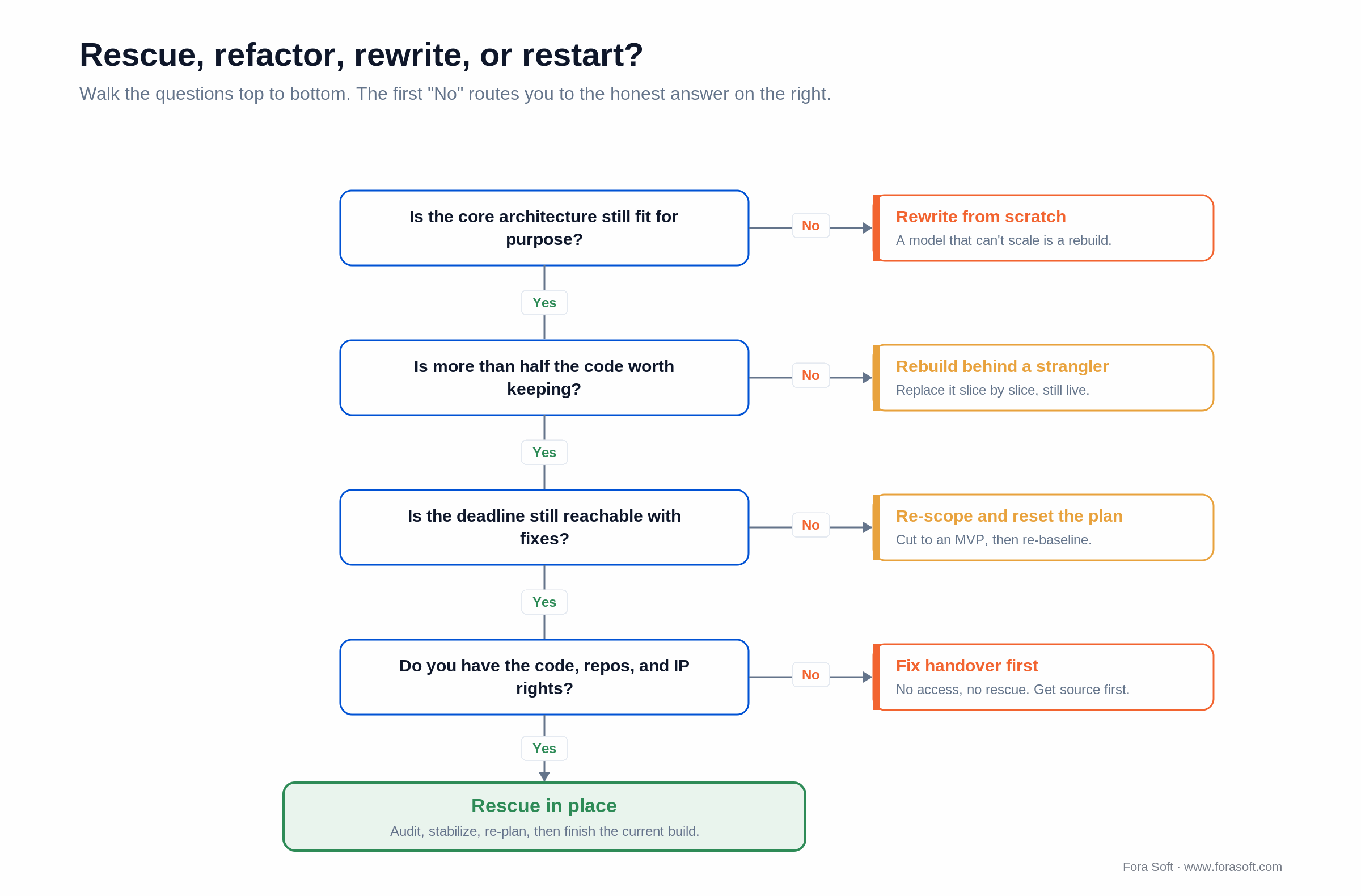

Figure 3. Four questions, top to bottom. The first “no” is your honest answer — rescue in place is the reward for four yeses.
Is the core architecture still fit for purpose? If the framework or data model fundamentally can’t scale to what you need, no amount of patching helps — that’s a rewrite. If it’s sound but messy, keep going.
Is more than half the code worth keeping? If most of it is salvageable, rescue in place. If most of it isn’t, the smart pattern is usually a strangler: wrap the old app and replace it slice by slice while it keeps running, so you’re never down and never doing a scary big-bang cutover.
Is the deadline still reachable with fixes? If not, the answer isn’t to work weekends — it’s to re-scope to a believable MVP and re-baseline. Do you have the code, repos, and IP rights? If not, that’s the first thing to fix, because there is no rescue without access.
Reach for a full rewrite when: the architecture can’t support your roadmap and less than a third of the code is worth keeping. Below that bar, a strangler rebuild or an in-place rescue is almost always cheaper and less risky.
Step one: the code and delivery audit
Every serious rescue begins with an audit, not a keyboard. In one to two weeks, a good audit turns “it feels broken” into a scored map of exactly what to fix, keep, or throw away. It’s the cheapest insurance you’ll ever buy: a week of senior review against a build that’s already months late and tens of thousands over budget.

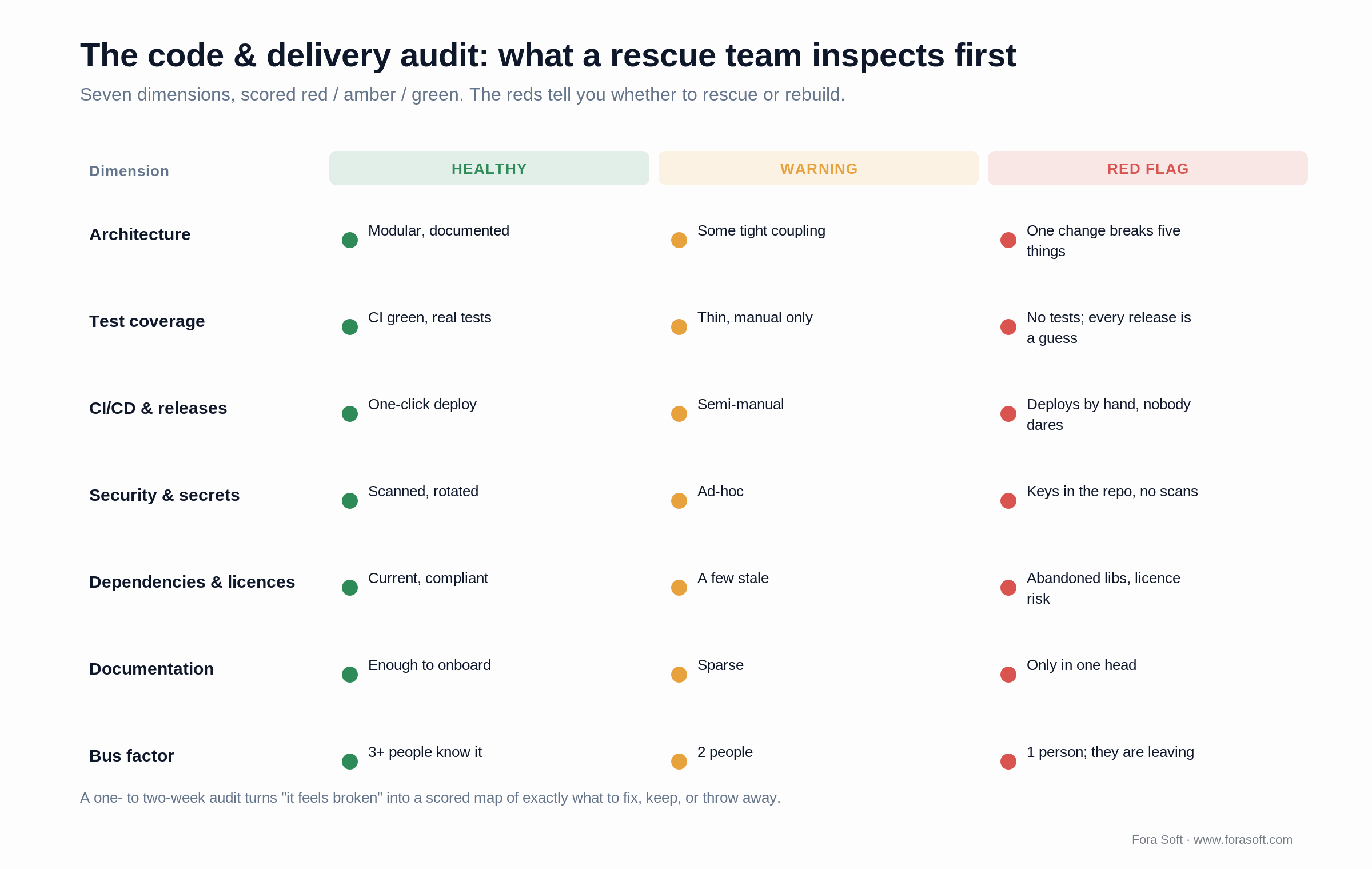

Figure 4. Seven dimensions, scored red / amber / green. The reds decide whether you rescue in place or rebuild.
We score seven dimensions, and each one has a clear tell. Architecture: does one change break five unrelated things? Test coverage: is there a real safety net, or is every release a guess? CI/CD and releases: one-click deploy, or a hand-cranked ritual nobody trusts? Security and secrets: scanned and rotated, or API keys sitting in the repo? Dependencies and licences: current and compliant, or abandoned libraries with legal risk? Documentation: enough to onboard, or living in one person’s head? Bus factor: do three people understand it, or one who’s already halfway out the door?
The audit produces two things: a red/amber/green scorecard and a prioritized fix list with rough effort. That’s what turns the rescue-or-rebuild decision from a gut call into an evidence-based one. If you want to run it yourself, our guide to code auditing lays out the criteria in detail.
The rescue, week by week
A rescue isn’t a heroic sprint; it’s a sequence. Stabilize, audit, re-plan, execute, prevent. The order matters: you stop the bleeding before you diagnose, and you bake in prevention rather than bolting it on at the end. For most stuck builds, twelve weeks is a realistic arc to a shippable, trustworthy product.

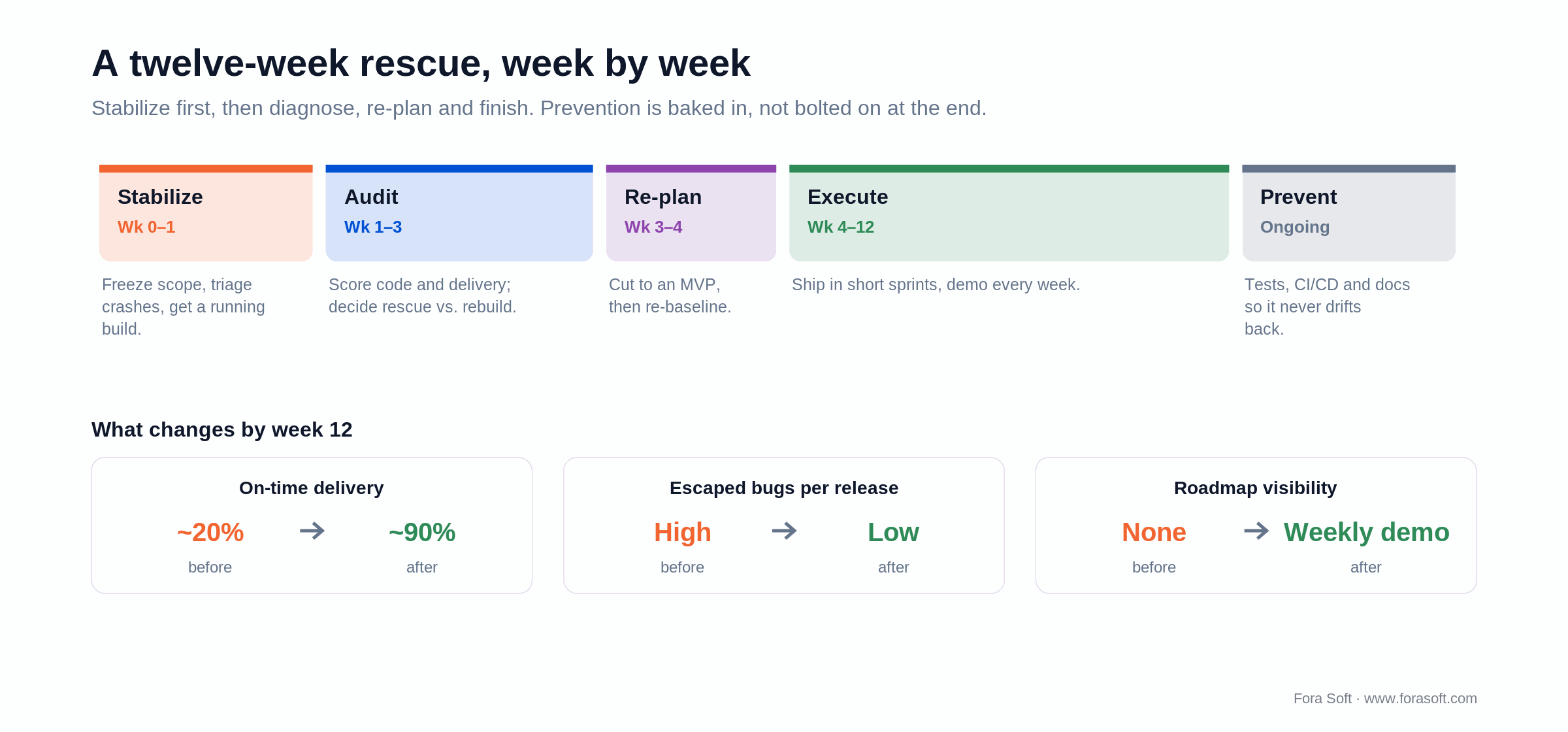

Figure 5. A typical rescue arc, and what changes by week 12: on-time delivery from roughly 20% to 90%, escaped bugs high to low, roadmap visibility none to weekly.
Weeks 0–1, stabilize. Freeze scope, triage crashes, and get a build that runs and can be demoed. Weeks 1–3, audit. Score the code and delivery, and make the rescue-versus-rebuild call. Weeks 3–4, re-plan. Cut to a believable MVP and re-baseline the timeline against evidence, not hope.
Weeks 4–12, execute. Ship in short sprints with a working demo every week — the demo is the status report, and it’s non-negotiable. Ongoing, prevent. Add the tests, CI/CD, and documentation that keep it from drifting back. By the end you’re not just caught up; you have a delivery system that won’t relapse.
Want this arc mapped to your project?
Send us your repo and current state. We’ll come back with an audit plan and a realistic date — usually within a couple of days.
What a rescue costs versus limping on or rebuilding
The honest answer: a rescue almost always costs less than either finishing badly or starting over. The reason is the cost of defects, and it’s one of the best-measured facts in software. Fix a defect in requirements and it costs roughly a unit of effort; the same defect caught in production can cost far more, per Barry Boehm’s classic data and NASA’s error-cost research.
Here’s the arithmetic. Say a six-month build is four months in, already 80% over budget, and still won’t ship. A full rebuild restarts all six months from zero. A rescue keeps what works: if the audit finds 55% of the code is sound, close to the median we see, you finish the remaining 45% plus a few weeks of hardening rather than a fresh half-year. That’s roughly 10 to 12 weeks of work against 24-plus for a rewrite, on the same product. Limp on with the current team and it’s neither: you keep paying the monthly burn while the date stays imaginary.
The audit that tells you which 55% to keep costs one to two weeks, and it’s the cheapest line in the whole exercise. It also prevents the most expensive mistake in software: paying to rebuild code that already worked. The defect math is the same lever. A problem caught during the audit costs a fraction of the same problem shipped to production, where Boehm and NASA put the fix at up to 100 times more. We use AI-assisted engineering to speed both the audit and the rebuild, which keeps our estimates conservative rather than inflated. If you suspect the deeper problem is price rather than progress, our guide on what to do if you’re overpaying breaks that down.
Rebuild instead of rescue when: the audit shows less than a third of the code is salvageable, the original stack is a dead end, or the security debt is so deep that a clean start is cheaper than remediation. Otherwise, rescue wins on cost.
The takeover playbook: access, IP, and knowledge transfer
This is the part almost every rescue guide skips, and it’s the one that sinks the most takeovers: getting clean access to your own product. Before a new team can save anything, you need the code, the credentials, the environments, and the legal right to change it all. No access, no rescue. Full stop.
Lock these down on day one:
- Source and history. The full Git repository, not a zip file — commit history tells the new team where the bodies are buried.
- Credentials and environments. Cloud accounts, CI/CD, DNS, third-party API keys, app-store logins. Rotate every secret as you take ownership.
- IP and licence clarity. Written confirmation that you own the code and that any third-party or open-source licences allow what you’re doing. This is where source-code escrow and a proper assignment clause earn their keep.
- Knowledge transfer. Even a few hours with the outgoing team saves weeks. If the relationship has soured, an audit reconstructs the map from the code itself.
A partner who treats handover as an afterthought will hand you a mess in six months. A serious one runs this checklist before writing a line of code. It’s also the moment to decide how you’ll staff the takeover — a dedicated team that owns the product end-to-end, versus augmenting your existing one.
Rescuing AI-generated and “vibe-coded” projects in 2026
A new kind of rescue landed in the last two years: products built fast with AI-generated code that stall the moment they meet real users. The demo worked. Then the app hit scale, or an audit, or a second developer, and nobody could explain how it worked. If that’s your project, you’re not alone, and it’s fixable.
The pattern is consistent. AI coding tools are genuinely fast at producing something that runs, which is why so much gets shipped without tests, without a coherent architecture, and without anyone who understands the whole. That’s classic technical debt, just accrued faster than a human team could manage it. The code isn’t worthless — but it needs the same audit, the same test net, and the same architectural review as any inherited codebase, applied sooner.
The upside cuts both ways. The same AI tools that created the mess can speed up the rescue: summarizing an unfamiliar repository, finding gaps in test coverage, and drafting the documentation that was never written. We use them exactly there — to accelerate the audit and onboarding — while keeping human engineers in charge of the architecture and the calls that actually matter.
What we learned taking over a live product
When BrainCert came to us, it wasn’t a rescue in the burning-building sense. It was a live education platform that needed to scale without breaking, which is its own kind of high-wire act. Take over a product real customers depend on and every change is a live change; there’s no clean-room rebuild option.
The plan was the arc from earlier in this guide, compressed. We stabilized first: got a reliable build and a picture of what actually ran under load. We audited the code and the delivery pipeline before touching features. Then we became the long-term engineering team, shipping in a steady cadence rather than heroic pushes.
The outcome is the point. BrainCert grew to 100K+ customers and passed 500M+ delivered classroom minutes, running as a video-heavy platform that has to stay up during live classes. We’ve done the same kind of stabilize-then-scale work under harder constraints, including HIPAA-bound healthcare products where downtime isn’t an option. Want a similar assessment of your product? Book a 30-minute call and we’ll walk your situation, no charge.
How to choose a rescue partner
Picking who rescues your project is a higher-stakes decision than picking who built it, because a rescue team inherits a mess and needs judgment, not just hands. Use vendor-neutral criteria — the ones below apply whether or not you ever talk to us.
| What to check | Green flag | Red flag |
|---|---|---|
| Audit first | Insists on a paid audit before quoting the fix | Promises to “save it” sight unseen |
| Honesty about restart | Willing to tell you to rebuild or stop | Says yes to everything you propose |
| Access discipline | Runs a handover and IP checklist on day one | Starts coding before you own the code |
| Senior-led | Puts senior engineers on the diagnosis | Staffs juniors and bills the ramp-up |
| Weekly demos | Shows working software every week | Reports status in slideware, not builds |
| Prevention built in | Leaves you tests, CI/CD, and docs | Fixes the symptom, leaves the debt |
Notice what’s not on the list: the lowest bid. In a rescue, the cheapest quote is often the most expensive outcome, because it usually means juniors relearning the same lessons on your clock. Weigh judgment and honesty over rate. A partner who’ll tell you the hard truth about a restart is worth more than one who tells you what you want to hear.
How to keep it on track after the rescue
A rescue that relapses isn’t a rescue. The difference between a project that stays healthy and one that drifts back is measurement — a few honest numbers watched every week. Track three buckets and you’ll see trouble coming while it’s still cheap to fix.
Delivery KPIs. Sprint predictability (did we ship what we committed?), lead time from idea to production, and the gap between planned and actual dates. When predictability drops below about 80% for two sprints running, something’s wrong — go look before the date moves.
Quality KPIs. Escaped defects (bugs found in production, not testing), reopen rate, and test coverage on the code that matters. Rising escaped defects is the earliest signal that the safety net is fraying again.
Reliability KPIs. Uptime, error rate, and deployment frequency. A team that deploys often and safely has a healthy pipeline; a team that dreads releases is accumulating the exact debt the rescue just paid off. If load is the worry, our guide on projects that can’t handle the load goes deeper.
When NOT to rescue
Honesty sells better than optimism, so here’s the counter-position: sometimes the right move is to stop, not to save. A good rescue partner will tell you this, even though it costs them the bigger contract. Walk away or restart when the evidence says the current path is a sunk cost.
Don’t rescue when the audit shows the architecture fundamentally can’t support your roadmap and almost none of the code is worth keeping — that’s a rewrite wearing a rescue’s clothes. Don’t rescue when the product itself no longer matches the market, because finishing the wrong thing on time is still failure. And don’t rescue when the expectations behind the project were never realistic; reset those first, or the next team inherits the same trap.
The test is simple. If the honest audit says less than a third of the work is salvageable and the goal itself still holds, restart cleanly. If the goal no longer holds, stop and rethink before spending another dollar. Throwing good money after a doomed plan is the one mistake an audit exists to prevent.
Rescue-readiness in five questions
Before you commit to a rescue, answer these five questions honestly. They’re the fastest way we know to sort a fixable project from a doomed one. If you can’t answer three of them, that’s your first task.
1. Can you get a working build today? If not, that’s the real status — and the first thing to fix. 2. Do you own the code, repos, and IP? No access, no rescue. 3. Is the core architecture sound? Messy is fine; fundamentally unscalable is a rewrite.
4. Is more than a third of the work salvageable? Below that, restart honestly. 5. Does the goal still hold? If the market moved, fix the plan before the code. Five yeses means rescue in place with confidence. A couple of noes means audit first. Mostly noes means it’s time for a harder conversation, and we’re happy to have it with you.
Not sure how your project scores?
Answer these with an engineer, not a salesperson. Book a free 30-minute call and we’ll score it with you, live.
Frequently asked questions
What is software project rescue?
Software project rescue is the structured recovery of a software build that’s late, over budget, or failing. It typically starts with a code and delivery audit, then stabilizes the product, re-plans the scope, and finishes it — either with the existing codebase or a partial rebuild, depending on what the audit finds.
How do I know if my project needs rescue or just more time?
Count the structural red flags: bugs reopening faster than they close, only one person understanding the code, and no working build you can demo. One or two soft warnings is a coaching problem. Three or more reds, or a release date that’s moved twice with no structural change, means it won’t fix itself — it needs an audit.
Should I add more developers to catch up?
No. Brooks’s Law holds that adding developers to a late project makes it later, because ramp-up and coordination cost more than the new hands add. Communication paths grow as n(n−1)/2. The fix is to cut scope and keep a small senior team, not to grow the crowd.
Is it cheaper to rescue or rebuild from scratch?
Usually rescue, if more than a third of the code is salvageable — which it is in most audits we run. Rebuilding throws away working code and restarts the clock. The deciding factor is the audit: it tells you exactly how much is worth keeping, so you rewrite only what you must.
How long does a software project rescue take?
For most stuck builds, about twelve weeks: one to two weeks to stabilize and audit, a week to re-plan, then roughly eight weeks of execution in weekly demos. Larger or more damaged products take longer, but the arc — stabilize, audit, re-plan, execute, prevent — stays the same.
What if I don’t have access to the source code?
That’s the first thing to fix, because there is no rescue without it. You need the full Git repository, all credentials and environments, and written confirmation that you own the code and its licences. A serious rescue partner runs this handover checklist before writing any code.
Can you rescue a project built mostly with AI-generated code?
Yes. AI-generated or “vibe-coded” products often run in a demo but lack tests, a coherent architecture, and documentation — the same technical debt as any inherited codebase, just accrued faster. The rescue is the same: audit, add a test net, review the architecture, and stabilize.
Will a rescue team tell me if my project can’t be saved?
A good one will. If the audit shows the architecture can’t support your roadmap and almost none of the code is worth keeping, the honest answer is a clean restart, not a patch. A partner who says yes to everything is selling hours, not judgment.
